OLGA-Well-Kill A Poweful Tool for
Blowout and Kill Modeling


ABSTRACT

A new adaptation of a proven flow simulator is aiding blowout contingency planning. Most important wells require a blowout contingency plan. Part of that plan includes relief well intervention. The flow simulator distinguishes between workable and difficult intervention schemes. It suggests any needed modifications in original well design and it makes crisis management quicker, cheaper and more effective. This paper describes the power of using this simulator for both surface and relief well hydraulic kill planning.

INTRODUCTION

Planning kill strategy for a 1989 underground blowout in the North Sea required development of an improved flow simulator. The hydraulic kill simulator was based on the industry-standard, two-phase pipe flow model, OLGA. After the project, the planning team realized that they gained considerable advantage from using a transient two-phase flow simulator for comparing various kill scenarios. Since that time the OLGA-WELL-KILL simulator has been used successfully for a number of intervention design plans.

In the event of a major blowout, the speed at which rescue and intervention equipment and personnel are mobilized is critical for the preservation of life, property and the environment. The first priorities of these emergency operations are personnel evacuations, oil spill containment and salvage of the reservoir, platform and well.

To respond quickly and efficiently to these emergencies, operators have devised and supported emergency response plans with the necessary resources and infrastructure to react immediately if required. Unfortunately, the only way to test the true effectiveness of a response strategy is during an actual emergency. Only after the events can one evaluate results and make modifications.

It is this reasoning, in the aftermath of recent major blowouts in the North Sea, that operators and regulatory authorities are re-evaluating the status of emergency response plans under their jurisdiction. Their purpose is to assure that lessons learned from these events are documented and that all operators incorporate appropriate improvements into their emergency procedures.

One component of this post evaluation process indicated that additional preparation for regaining control of a blowing well is justified. Even though the probability of a blowout is small, the consequences in safety, cost and pollution could be catastrophic. For these reasons, "solving the problem" contingency plans are being added to the existing emergency response plans. This effort will eventually include surface, subsea and relief well intervention.

A primary objective of this contingency planning process is to evaluate the current level of technology and operational expertise available for a blowout intervention operation. Shortfalls can then be identified and appropriate action taken to reduce the deficiencies. One problem identified early in this evaluation was the difficulty in analyzing heavy mud hydraulic kills, in a two-phase blowout flow regime, with existing steady-state flow models.

These models cannot easily evaluate the time transients of the kill process or deal with complicated multiphase flow regimes, flow paths and interaction with the reservoir. Example deficiencies include the inability to determine the rate at which mud will U-tube from a relief well upon intersection with the blowout, the rate at which bottom hole pressure will build up, or the kill volume required. Steady-state models cannot tell whether gas will migrate during the pumping operation, how long peak HHP loads will be required or how changing temperatures will effect overall design.

The ability to analyze hydraulic kill scenarios quickly and find their effect on the rest of the intervention operation is critical to project success. A specialized need was therefore identified for a multiphase, time-transient, flow simulator designed for easy blowout kill analysis. This need was the driver that motivated the continued modification of the pipeline code for well flow and kill simulations.

THE CONTINGENCY PLANNING OBJECTIVE

The successful planning and execution of a complicated blowout intervention operation requires the careful coordination of several specialized technical disciplines. The development of a strategy is an iterative process. It requires evaluating several alternatives, analyzing risks and making tradeoffs, before reaching agreement between the operator, partners, and regulatory authorities. These decisions carry substantial safety, environmental and economic implications. The person or company responsible for the intervention will perform with confidence if proper remedial contingency is performed beforehand.

All blowouts and subsequent intervention techniques are inherently different. This makes it impractical to cover all possibilities in specific planning and execution procedures. However, a structured guideline, with examples, is essential to avoid overlooking critical steps in the development of the final well control strategy, where many decisions are made under stressful conditions.

The basic considerations include:

RELIEF WELL PLANNING REVIEW

This paper illustrates the development of a single component of a relief well plan. The following review shows how the flow simulator fits into that plan. The first step in this process is to define the problem or "blowout scenario" accurately before expensive solutions are planned. It is important to remember that the blowout scenario controls the majority of the planning process. If the scenario is misinterpreted, the blowout intervention plan may prove inadequate and dangerous. The first decision point is to evaluate the hydraulic kill point, placing the depth, proximity, orientation and position tolerance of the relief well intersection with the blowout wellbore. This most critical step influences the entire relief well planning process and requires an iterative analysis of all data as a system.

Once a point is chosen, two parallel planning paths must be evaluated. One side considers a drilling design to place the relief well at the chosen point considering all constraints. The other is to design the kill hydraulics and associated pumping and special equipment to carry out the kill operation at the point chosen. If both sides cannot achieve their goal with a reasonable degree of confidence, then the kill point must be re-evaluated.
The new flow simulator evaluates the kill hydraulic portion of the overall relief well design.

FLOW SIMULATOR DESCRIPTION

The well kill simulator, OLGA-WELL-KILL, stems from the dynamic two-phase pipe flow simulator OLGA2. Development started in 1980 at Institutt for Energiteknikk (IFE) as a project for Statoil, mainly aimed at simulation of terrain-induced slugging in pipelines. From 1983, the development was carried out under the joint IFE/SINTEF Two-Phase Flow Project with support from a group of oil companies. Emphasis was placed on verification of the model against data from different experimental facilities, including the results from the 8-in. diameter, 1000 m and 90 bar experimental flow loop at SINTEF. Several new applications were added, such as gathering pipeline networks, compressors, heat exchangers, separators, chokes, reservoir inflow, leaks and plugging. The model has been used extensively and applied to a variety of situations such as pipeline design simulations, pipeline shut-in, start up, and rupture studies.

fig2.gif (7298 bytes)During the kill planning for the Saga Petroleum underground blowout (well 2/4-14 in 1989) 3-4, it was discovered that no suitable tool exists for dynamic estimation of kill fluid volumes and times when a number of kill points and options are to be evaluated. The more common approach of using conventional (steady state) tubing hydraulics programs is time consuming and can be inaccurate, due to the need for a manual step-wise approach. Applying the dynamic two-phase model OLGA to the problem improved modeling capabilities, accuracy and turn-around time. The team could then compare different kill options for both direct kill and relief well intervention.

A Saga Petroleum research program has generated a new simulator, OLGA-WELL-KILL, specially adapted to well flow kill applications. This simulator has been used on actual blowouts and for contingency planning. Comment from this work helped tailor features of the code toward the answers needed by the end users, without compromising on the complexity or accuracy of the flow modeling process itself. The model program now runs on portable computers.
During a blowout kill, up to six fluids can be present simultaneously in a well; reservoir oil, gas and water, kill water, intermediate and final kill mud. Simulations handle this by first simulating the dynamics of a liquid/gas biphasic flow regime, then comparing this to a simulation using averaged properties in a light phase. The kill phase is then introduced and a dynamic two-phase simulation performed until a steady state condition is reached. Afterwards, the next phase can be introduced and the simulations can be restarted at any time step.
Modeling is accomplished using a number of controllers set to contain the simulation within the physical constraint of the real blowout.
fig3.gif (8064 bytes)The controllers can, for example, be set on these parameters:
•    Pump rate
•    Pump horsepower
•    Formation collapse pressure
•    Casing burst pressure
•    Surface injection pressure
•    Bottom hole pressure (Min/Max)

The simulation modeling includes:

•    Pump performance
•    Non-Newtonian fluid flow (for mud)
•    Fluid temperature and pressure response
•    Inflow modeling (multiple if needed)
•    Leaks (multiple if needed)
•    Back pressure (outflow conditions)
•    Several reservoir inflow models
•    Variable reservoir pressure
•    Path chokes (critical and sub-critical)

In practical use, the modeling is usually taken through a number of steps, starting with a PVT fluid characterization of the reservoir fluids. The blowout is then modeled to match all available data (Fig. 2). This can, for certain blowouts, provide a valuable exercise in itself. It eliminates uncertainties. It is always much easier to solve the actual problem at hand than to approach a well kill by trial and error.

fig4.gif (7467 bytes)The next step is to set up a constant rate kill simulation to work out the range for the simulation of the actual dynamic kill. This is also useful in evaluating allowance for losses between wells (for relief well kills) as well as for the kill fluid density, and for velocity and pressures at critical points in the blowout path. The fully dynamic simulations can then incorporate all the actual constraints in the kill such as casing pressure ratings, fracture pressures, inflow performance and reservoir pressure (dynamically versus time, if necessary), pumping plant and mud properties (Fig. 3).
The simulation yields an actual pump schedule vs. time (with rates and pressures at any chosen point in the flow path). If needed, a number of sensitivities can be developed to evaluate kill effectiveness during the actual pumping. This later step can often prove useful when there are unknowns in the kill (such as communication between relief well and blowout well, actual blowout flow path, or reservoir performance).



CASE HISTORY EXAMPLES

These examples are based on genuine contingency plans for hypothetical blowouts. Simulations use actual well data.
Scenario 1. A hypothetical relief well intervention was designed assuming a blowout to the surface of a shallow gas well. In this case, 13 3/8-in. casing has been set at 1300 m TVD with 12 1/4-in. open hole drilled through the reservoir to 1450 m TVD. The drillpipe is sheared and dropped and the blowout flow path is up the annulus to the rig-floor.

fig5_6.gif (8372 bytes)The kill point illustrated here assumes achieving communication by direct intersection with the wellbore just below the 13 3/8-in. casing shoe. This point is 140 m TVD above the top of the blowing zone. The reservoir is normally pressured with a gradient of 1.08 sg EMW, the permeability is 400 md with a net thickness of 30 m. The temperature is 54 °C, the fluid is dry gas and the fracture gradient is 2.46 psi/m (Fig 4).

After performing a PVT analysis on the blowing gas, a non-linear inflow performance (IPR) curve for the reservoir was developed. This relation is important in an open flow gas blowout due to the potentially low flowing bottom hole pressure. A linear PI will produce an unrealistically high blowout flow rate and unnecessarily increase the kill hydraulic requirements (Fig. 5).
On the basis of on this IPR curve and the blowout flow path a steady state flow rate was calculated at 41 MMscf/d of gas with no condensate. The flowing bottom hole pressure was 500 psi (static 2050 psi). The possibility of massive sand production and bridging or hole collapse are strong possibilities under these conditions. For this exercise, flow remains constant. Two kill fluids were evaluated, 1.14 sg water-based mud and seawater. The constant injection of kill fluid into the well at the chosen kill point produced the following results for mud then water:

Pump rate (bpm)  40   50   60   80
Kill time (m)   none   32   14   7
Volume (bbl)   -   1600   840   560
Pump rate (bpm)  100   110   120   130
Kill time (m)   none   14   8   6
Volume (bbl)   -   1540   960   780

These values give the minimum rates to control the well dynamically, assuming no losses to the formation. The kill time and volumes indicated are times at which the influx stops. Additional time and volumes will be required to flush gas from the well. The seawater kill must be followed by mud with sufficient density to control the static reservoir pressure.
The next iteration of the hydraulic planning process is to design a relief well to intersect at the chosen kill point. Fig. 4 shows basic design.

The constant injection results provide the starting data required for the controlled rate injection, where the full dynamic kill is simulated with the relief well attached. For this paper only the mud kill will be discussed. The controller limits for this simulation were set at 7500 psi injection pressure, 2500 psi bottom hole pressure and a starting pump rate of 50 bpm. The simulator will adjust the injection rate to stay within these limits after intersection. Figure 6 gives a double "y" plot of flow rate and cumulative kill mud volume versus time. Observe that immediately upon intersection with the blowout wellbore, mud U-tubes from the relief well at rates approaching 280 bpm. This is due to the extreme pressure differential between the relief well and the flowing blowout wellbore and the large diameter flow path. If the injection rate at the surface could keep up with this suction rate at the intersection, the well would be killed in just over 10 minutes with a cumulative mud volume of just over 1000 bbl.

fig7_8.gif (7845 bytes)Since injection rates this high are not practical, this information is valuable in evaluating the risks associated with this kill alternative. For example, if a mechanical problem prevented immediate kill mud injection, the relief well could reach a blowout situation in about 7 minutes.
Figure 7 shows a double "y" plot of flow rate and cumulative kill mud volume versus time with a maximum injection rate of 50 bpm at the surface. In this case the difference between the surface injection of 50 bpm and the bottom hole suction is replaced by air. This scenario yields a kill time of Å50 minutes and a cumulative volume of Å1800 bbl. The hump in the flow rate curve at 40 minutes is caused by the air circulating around the blowing well.
Figure 8 shows a double "y" plot of gas outflow and kill mud outflow versus time. The kill fluid outflow, between 5 and 10 minutes corresponds to the kill pumping volume. However, the outflow indicated between 25 and 60 minutes occurs after the pumps have stopped. Further evaluation of the two-phase fluid distribution in the blowout wellbore indicated that the kill mud was falling to the low side of the 60° inclination hole while pushing the gas to the high side and trapping a gas bubble below the intersection point. This bubble migrated to the surface after the pumps were stopped and ejected a substantial volume of mud from the blowout well.
If this reduced mud column had been insufficient to hold the reservoir pressure, the well would have started flowing again. This simulation demonstrates the need to continue circulating at a low rate for several blowout hole volumes after the well is statically dead.

Scenario 2. In this example a hypothetical relief well intervention was designed for a deep high pressure, high temperature exploration well. In this case, 9 5/8-in. casing has been set vertical at 4600 m with a leak-off test of 2.20 sg. The 8 1/2-in. hole intersected the top of a hydrocarbon pressure compartment at 4900 m TVD, 100 m higher than predicted and is penetrated by 2 m. The 5-in. drillpipe is sheared and dropped to the bottom. The flow path is up the annulus, with no restrictions, to the seabed.

Two kill points were evaluated, one at the 9 5/8 in. shoe, 280 m above the reservoir and another at  the reservoir top. Both kill points assume direct communication through open hole. The position tolerance required at intersection is +/- 1m. Data on the sandstone reservoir is estimated as:

PI (estimate)   30 Sm3/day/bar
Depth   4900 m TVD
Permeability   10 md
Pressure (TD)   1030 Bar (2.14 sg)
BHT   180 C
Fluid   Gas/cond.
GCR   500 Sm3/Sm3
Bottom Hole Pressure  750 bar
Gas Rate   2 MMSm3/d
Condensate Rate   4000 Sm3/d

The 9 5/8-in. intersection can be drilled much quicker and with a higher probability of achieving the +/- 1m placement criteria. However, there is risk the kill operation may exceed the fracture pressure at this depth. The deeper kill point has hydraulic and fracture strength advantages. However, the high bottom hole temperatures and depth will cause serious directional drilling control problems thus increasing the risk that the well might miss +/- 1m intersection. The simulator was used to determine if the off-bottom kill has acceptable risk with respect to the kill hydraulics (Fig 9).
Based on the assumed inflow performance of the reservoir, the hydrocarbon composition, and the flow path, the following blowout rates were computed:

Two different kill fluids were evaluated, 2.2 sg water-based mud and seawater. The minimum flow rate for a seawater kill was 100 bpm at the shoe and 90 bpm at TD. Both of these rates would require unrealistically large pumping plants and were not considered further.

The constant injection iteration at the shoe kill point required a minimum flow rate of 35 bpm to a achieve a kill in 64 minutes using 2240 bbl of mud. A 40 bpm rate reduced the kill time to 27 minutes and a corresponding 1080 bbl of mud. A 35 bpm injection rate at the bit would kill the well in 34 minutes using 1190 bbl of mud. Initial injection rates of 40 bpm for the shoe intersection and 35 bpm for the bit intersection were chosen for the full transient simulations with the relief well attached.

fig9.gif (11223 bytes)Figures 10-12 illustrate double "y" plots of mud injection rate and cumulative mud volume, pump power and injection pressure, and bottom hole pressure and pressure at the shoe respectively, for the casing shoe kill scenario. Figure 12 shows that fracture pressure at the shoe is exceeded slightly just as the gas below the kill point is bullheaded back into the formation. Figure 13 illustrates the bottomhole pressure and casing shoe pressure for the bit kill scenario. This plot shows pressure remains below fracture gradient for this intersection point.

These simulations further substantiate the difficulty in planning a kill for a deep, pressured blowout. Deep intersection can handle kill hydraulics, but risks intersection failure. Casing shoe intersection is easier but pumping will fracture the rock. Further investigation would be required on the rate and linearity of the loss to determine if the hydraulics at this kill point are too risky to attempt.

Scenario 3. In this example a hypothetical relief well intervention was designed for a normally pressured gas condensate blowout during completion. In this case, 7-in. production casing has been set through four producing reservoirs, each with different hydrocarbon compositions, temperatures and IPR curves. A single 3 1/2-in. completion string is used. Each zone has been perforated and isolated from others by three production packers. Fluids from each zone mingle in the production tubing. The blowout is assumed after perforating the last zone. All zones are flowing to the surface with only the wireline in the casing (Fig. 14).

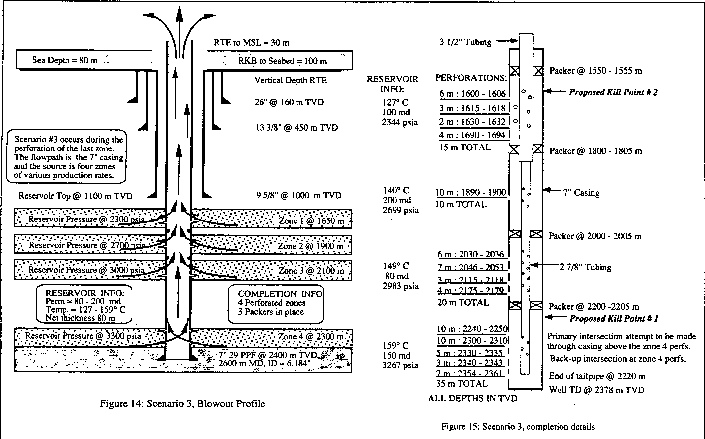

fig10_11.gif (7449 bytes)This scenerio evaluates kill points at the top of the lower set of perforations in zone 4 at 2200 m, and at the top of the first set of perforation in zone 1 at 1600 m. The extreme temperature gradient of this well, 1.8 °C/30 m, will make an intersection at 2200 m complicated due to directional drilling limitations at 160 °C. Therefore an intersection at 1600 m is attractive if the well can be controlled at this depth without exceeding the fracture gradient. The hydraulics at this depth are complicated by the multiple flowing zones with different characteristics and pressures. The simulator, however, can handle these multiple zones easily (Fig. 15).
Based on reservoir and fluid property characteristics the blowout rates for each zone are:

Zone   Reservoir P [psi]  Flowing P [psi]  GasRate
MMscf/d
1   2300   2100   20
2   2700   2300   60
3   3000   2350   40
4   3300   2400   80
Total       200











Two kill fluids were evaluated, 9.5 ppg water-based mud, and seawater, for both intersection points. The steady injection rate iteration indicated that a minimum of 35 and 45 bpm of mud and 40 and 50 bpm of seawater would be required to kill the well at zone 4 and zone 1 respectively. Two relief wells were planned based on the intersection points. Full dynamic simulations were based on these initial injection rates with the relief well attached. Table 1 summarizes results.

The well can be controlled from an intersection in zone 1 without exceeding the fracture gradient and without excess pumping requirements.

Scenario 4. This example is based on a gas and water blowout during a workover with a snubbing unit. While fishing 2 3/8-in. tubing a hole developed in the production casing which caused failures in the 9 5/8-in. and the 13 3/8-in. casing.
It burst just below the wellhead. The well was soon brought under partial control with the flow manifolded to allow pressure to bleed off the annuli and to separate the gas and water.

fig12_13.gif (7017 bytes)The mechanical situation downhole was complicated, with considerable uncertainty about the flow path from the reservoir to the surface. At the time the problem occurred the tubing had been removed to 4500 ft just above a nipple. It was assumed this nipple was obstructing the tubing ID and a 270 ft, 4 1/2-in. OD wash-pipe assembly with an outside cutter had consequently been run in the hole, swallowing the tubing. There was no pressure seal between the tubing and wash pipe but the tolerances between the 5 1/2-in. production casing and the 4.5-in. OD of the wash pipe provided a tight restriction for flow. Noise logs run through the work string indicated there were holes in the casing at 4500 and 1600 ft MD. This allowed a leak into a 4 Darcy permeability water sand if shut in at the surface. A proposal was made to pump 18 ppg mud down the work string at a maximum rate in an attempt to stop the flow. However, due to the unknown flow path and known holes in the casing, there was some risk that the mud flow might increase the hole size in the casing and cause the blowout to broach to the surface.

The simulator evaluated some of these risks. Various flow paths from the reservoir to the surface were simulated and compared to the measured flow at the surface. It was originally suspected the flow path was behind the casing from the reservoir. Simulation results, however, indicated that the gas was more likely flowing up the 2 3/8-in. tubing from the reservoir, around the wash pipe and up the 5 1/2 by 2 7/8-in. annulus to the surface. This simulation most closely matched flow measured at surface. A pump test was also simulated by injecting fresh water down the work string at 3.5 bpm, mixing with the gas and saltwater flow in the wash pipe. This was compared with the assumed flow path and the changing outflow conditions. These results also supported the model-predicted flow path (Fig. 16). Confident of the flow path, a dynamic kill simulation was made using the 18 ppg mud pumped down the work string at 3 bpm.


fig16.gif (9493 bytes)These simulations indicated the wash pipe would create sufficient friction pressure during pumping to bullhead the gas and water back to the reservoir from 4400 ft to 10,900 ft. The inflow would be stopped in 25 minutes, with 175 minutes required to flush all the gas and water from the well. The injection rate was reduced from 3 bpm to 1 bpm after 60 minutes. These simulations were performed assuming a hole in the casing at 1600 ft with a back pressure of 695 psi.

SUMMARY AND CONCLUSIONS

A new computer program can simulate multiphase flow in a blowout and a relief well. The simulator comes from proven pipeline flow models. We have used the simulator to design kills for factual blowouts. More importantly, we believe the simulator provides a valuable tool for contingency planning. Results are both quicker and more accurate than previous methods.
The OLGA-WELL-KILL simulator can find a workable relief-well strategy before drilling begins and it can point out design changes to make contingent operations safer and cheaper.

The simulator adapts existing pipeline technology (developed with substantial funding) to hydraulic kill applications. The core code, which acts as the simulator engine, was extensively tested over the last 10 years and remains unchanged. Modifications allow quick analysis of transient multiphase flow regimes under a variety of complicated blowout and kill scenarios. Analysis can be made by pumping either from a relief well or directly into the blowout.

Experience and research have shown that the hydraulic kill design is a major driver in the overall intervention project, particularly in the case of relief well control. This capability to simulate blowout flow, temperature, kill fluid weights and volumes, hydraulic horsepower, pressures and other related parameters all with respect to time and at any point in the well, has not been available to the industry before.

The four examples here illustrate some capabilities. Other applications include:

•    Kill with different mud densities in the well
•    Partial losses during kill
•    Multiple blowout paths, cross flows and leaks
•    Multiple relief wells pumping at different rates
•    Underground blowouts from a drilling rig
•    Simultaneous bull heading and dynamic kill
•    Off bottom or momentum kills
•    Shallow gas blowouts
•    Horizontal well flow analysis
•    Slugging in long reach production wells
•    Rates required to circulate out a kick in high-angle or horizontal wells
•    Alternating gas and water injection
•    Sensitivity analysis by varying parameters

Soft intangibles are a hard sell. But the safety, environmental and economic risk of a major blowout in today's world are too high to continue the historical 'react-if-it-occurs' approach. The technology for successful intervention has, in most cases, matured to adequate levels, but every well requires adaptations. These adaptations are best evaluated before an emergency occurs. A solid contingency plan makes any well safer.
